Range Construction Blog
NOW OPEN
UPDATE 12-6-2016

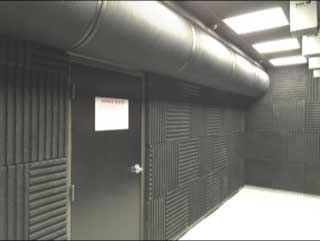

- Substantial completion, pending inspections.

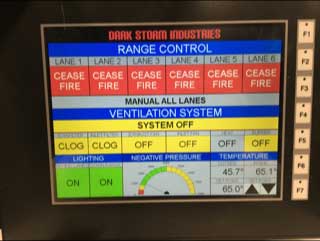

UPDATE 12-1-2016

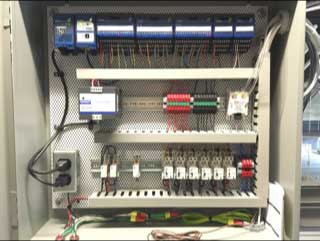

- Control systems installed and programmed
UPDATE 11-20-2016

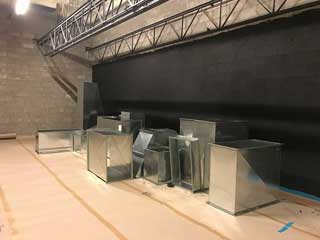

- Internal ducts and diffuser for heating / ventilation units installed

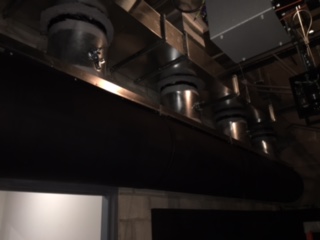

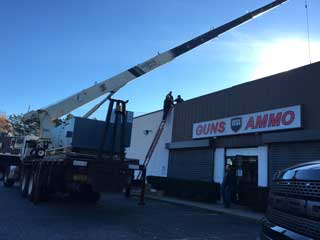

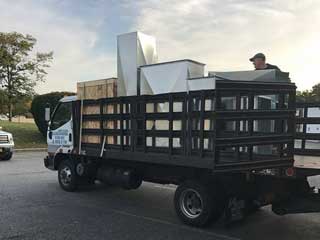

UPDATE 11-7-2016

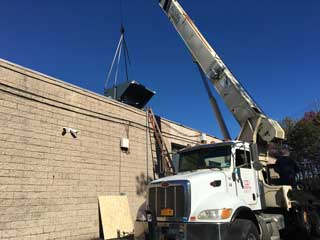

- Rooftop heating / ventilation units installed on the roof
UPDATE 10-30-2016
- The interior range fit out is nearly complete.

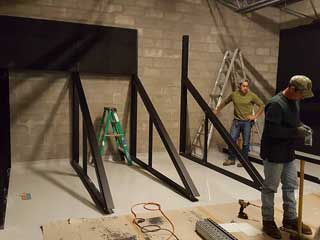

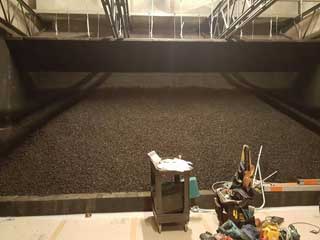

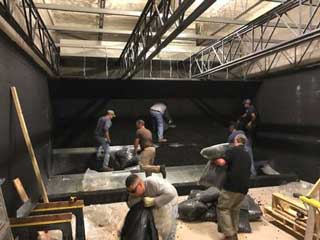

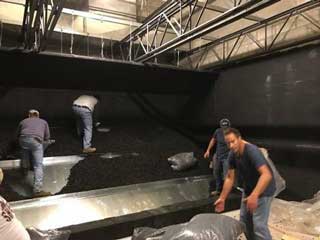

- The angled backstop with 10 tons of rubber chip is installed.

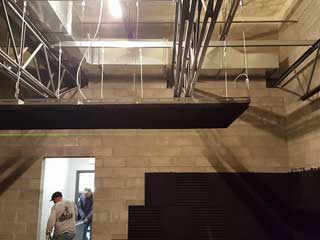

- The safety ceiling and safety baffles are installed.

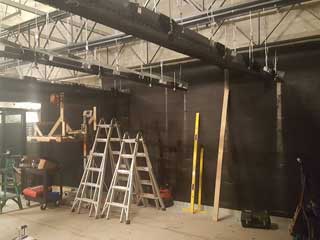

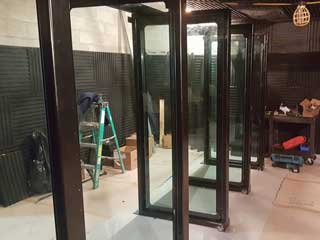

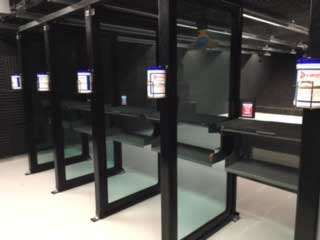

- The bullet resistant lane dividers and double shelves are installed

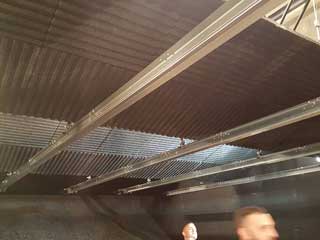

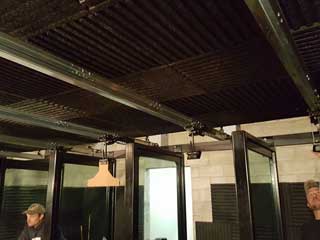

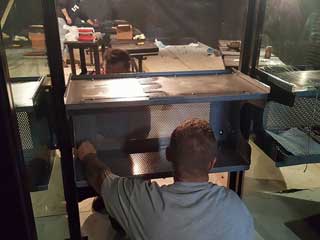

- The target travelers are hung and pending controls and testing
- The rubber panels for noise reduction and ricochet protection are being installed
UPDATE 10-20-2016

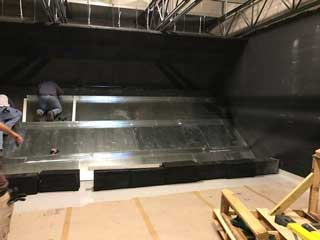

- The ventilation system duct work is being delivered and installed
UPDATE 10-10-2016
- Three coat epoxy / urethane floor now complete
UPDATE 10-3-2016

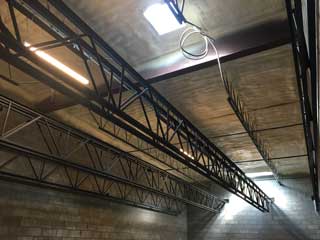

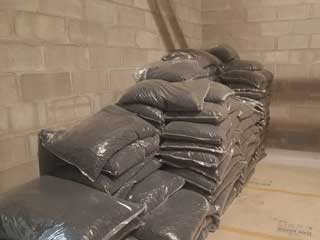

- Spray foam insulation for air seal and noise reduction installed.
UPDATE 9-27-2016

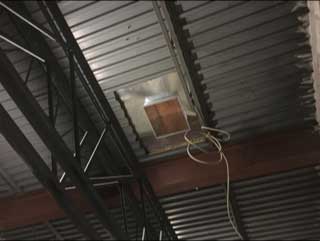

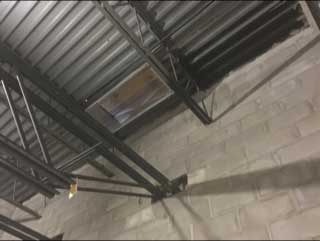

- Roof cut and curbs installed for both exhaust and make up air systems
UPDATE 9-20-2016
- Rooftop curbs arrived, pending installation
- Final HVAC ductwork measurements completed, ductwork in fabrication
UPDATE 9-7-2016

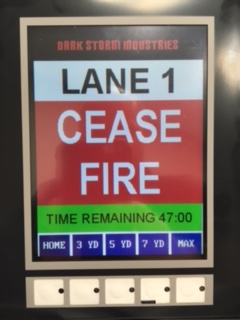

- PLC to control HVS (Heating & Ventilation System) as well as lane timing, target travelers and lighting has arrived and is being programmed.
UPDATE 8-22-2016
- Construction Permit approved and issued by Town
- Heating and Ventilation Equipment ordered
- Backstop, ceiling baffles and dividers ordered and in fabrication
UPDATE 8-20-2016

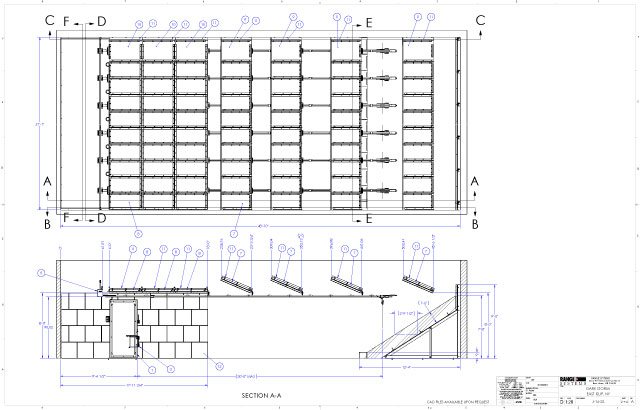

- Range Systems has completed the interior fabrication drawings for the baffles, dividers and backstop. They are being reviewed, commented on and should be released to fabrication shortly.


UPDATE 7-27-2016

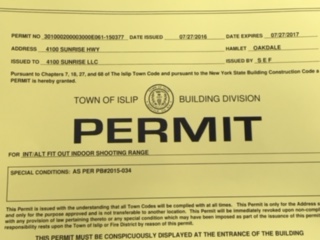

- Range construction permit has been issued!
UPDATE 4-13-2016
- Kick off meeting with Town Building Department Completed
- Architect and Mechanical Engineer hired and design process started
- Preliminary drawings are expected early May
- Range System selected as backstop and baffle supplied
- All Seasons selected as HVAC contractor
- Reviewing optinos for custom glass lane dividers
UPDATE 11-28-2015

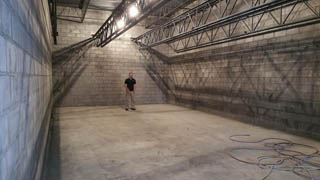

- The range walls are 100% complete and the ceiling baffle steel supports are now rigged to their final home.
UPDATE 11-24-2015

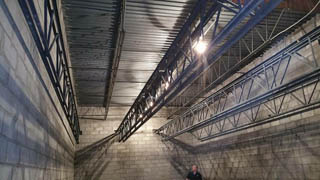

- The range walls are nearly complete. The steel bar joists that will support the ceiling baffles have arrived and are waiting for final placement.
UPDATE 11-20-2015

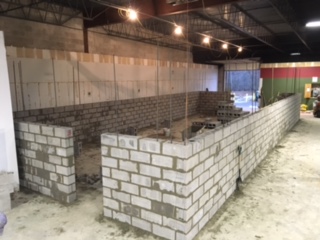

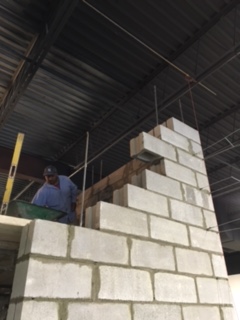

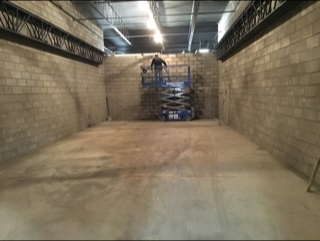

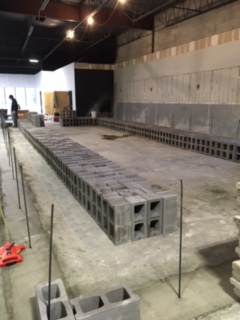

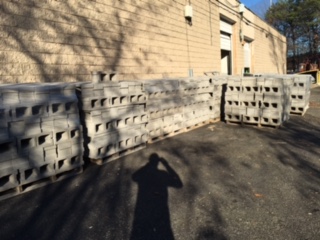

- Range walls are under construction. Over 2000 cement blocks need to be installed.

UPDATE 11-18-2015

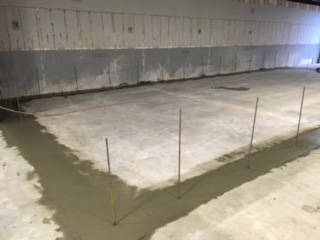

- Concrete footing is poured. The first of many deliveries of block is justed arrived.
UPDATE 11-5-2015

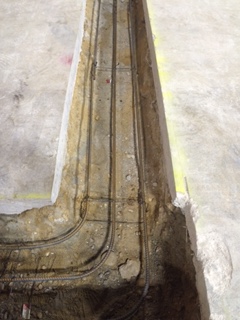

- Excavation of the footing is complete, rebar is installed, just waiting for the concrete.
UPDATE 10-31-2015

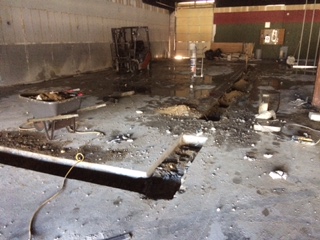

- Demolition is underway! The concrete floor is being cut and removed to allow for the installation of the concrete footing that will support the range walls.
